You own a plot of land and would like to divide it into several lots for sale or construction? In Morocco, a land subdivision is regulated and follows a precise administrative and technical process. Understanding it clearly will help you avoid delays and maximise the value of each lot.
STOPSIT walks you through every step, from the feasibility study to the delivery of individual title deeds.
What is a Land Subdivision in Morocco?
Under Moroccan law (Law No. 25-90 on subdivisions, housing groups, and parcel splits), a subdivision is any division of a property into two or more lots intended for construction, regardless of their area.
Whenever land is divided for building purposes, a subdivision permit is mandatory — even for just two lots.
- Original title deed or certified copy
- Cadastral plan of the parent plot (obtained from the ANCFCC)
- Recent ownership certificate (less than 3 months old)
- Urban planning certificate for the area (municipality)
- Copy of the owner's national ID or company statutes
The 7 Key Steps of a Subdivision
-
Feasibility study and urban planning review
Before any formality, check that the land is buildable under the applicable Development Plan (PA) or Urban Master Plan (SDAU). Maximum density, mandatory setbacks, and easements determine how many lots can be created.
-
Topographic survey and subdivision plan design
The surveying engineer carries out a precise topographic survey of the parent plot, then designs the subdivision plan: internal road layout, lot boundaries, green spaces, and utilities networks. The plan is produced in AutoCAD / COVADIS.
-
Compiling and filing the permit application
The file is submitted to the relevant municipality and Urban Agency. It includes the subdivision plan, the presentation note, ownership documents, and utility attestations (ONEE water, ONEE electricity, etc.). Processing timelines vary by municipality and can exceed theoretical deadlines — it's important to plan accordingly.
-
Obtaining the subdivision permit
After review by the municipality, Urban Agency, and technical services, the subdivision authorisation order is issued. This order specifies road, utility, and green space obligations to be completed before final acceptance.
-
Infrastructure works
The developer carries out the required works: roads (kerbs, surfacing), drinking water supply, drainage, electricity, street lighting, and green spaces. These works are inspected by municipal services and utility companies.
-
Official boundary surveys and ANCFCC file
After the works, STOPSIT carries out the official boundary survey for each lot: marker placement, as-built survey (plan as executed), and preparation of the cadastral technical file (DTC) for each lot. The DTC is submitted to the ANCFCC for the creation of individual title deeds.
-
Final acceptance and delivery of title deeds
The municipality issues the final acceptance of the infrastructure works. The ANCFCC then proceeds with publication and delivery of individual title deeds for each lot, allowing the developer to transfer them with full legal security.

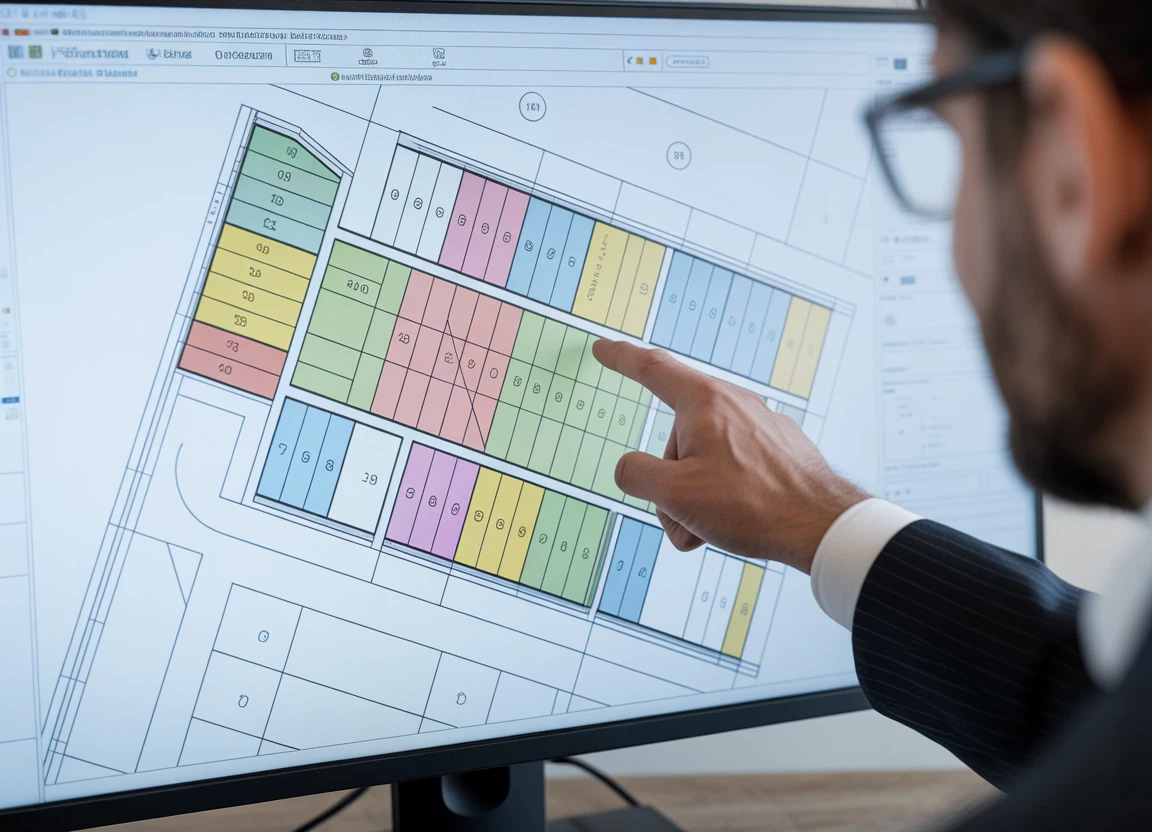

Subdivision plan — AutoCAD / COVADIS
Average Timelines
- 2 to 4 months for processing and obtaining the subdivision permit — timelines can be longer depending on the municipality and file complexity
- 4 to 12 months for infrastructure works (depending on scale)
- 3 to 6 months for ANCFCC title deed creation
Overall, a mid-sized subdivision (10 to 50 lots) typically takes between 12 and 24 months from initial studies to title deed delivery.
- Starting works before obtaining the subdivision permit (criminal offence)
- Selling lots before final acceptance and title deed delivery
- Overlooking right-of-way or public utility easements in the design
- Undersizing internal roads relative to the municipality's requirements
Why Entrust Your Subdivision to STOPSIT?
- Topographic survey of the parent plot
- Subdivision plan design (AutoCAD / COVADIS)
- Permit application file preparation
- Official boundary survey for each lot
- Cadastral technical files (DTC) for the ANCFCC
- Follow-up through to title deed delivery
With over 2,900 cadastral files processed since 2005 and direct experience on subdivisions in Kénitra (Al Omrane, Jnane TR 2), you benefit from proven expertise.
